Culvert Cleaning & CCTV Survey | Kier NR&N
50m
Culvert Length
8
Days completed in
£19,490
Contract Value
Project Overview
LOCATION
Whitchurch, SY13 1RS
SCOPE
Culvert cleaning and CCTV survey following a major breach on the Llangollen Canal, restoring drainage and assessing structural condition.
PROGRAMME
8 weeks
CONTRACT VALUE
£19,490
Method of Works
Culvert Clean & CCTV

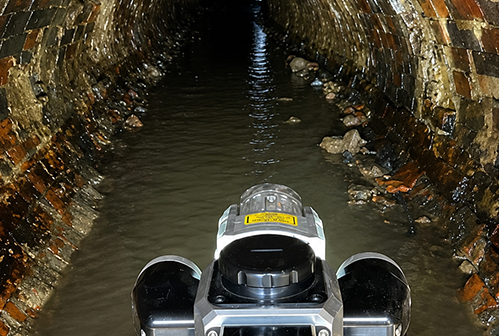

~50m of 1200mm x 1200mm brick culvert cleaned and surveyed to full WRc standard
Downstream Twin Pipes
~33m of twin 225mm clay pipes cleaned and CCTV completed (Stage 2)
100% Silt Removal
All pipes 100% full of debris due to the breach – finished silt levels reduced to less than 10%
Portable Equipment Deployed

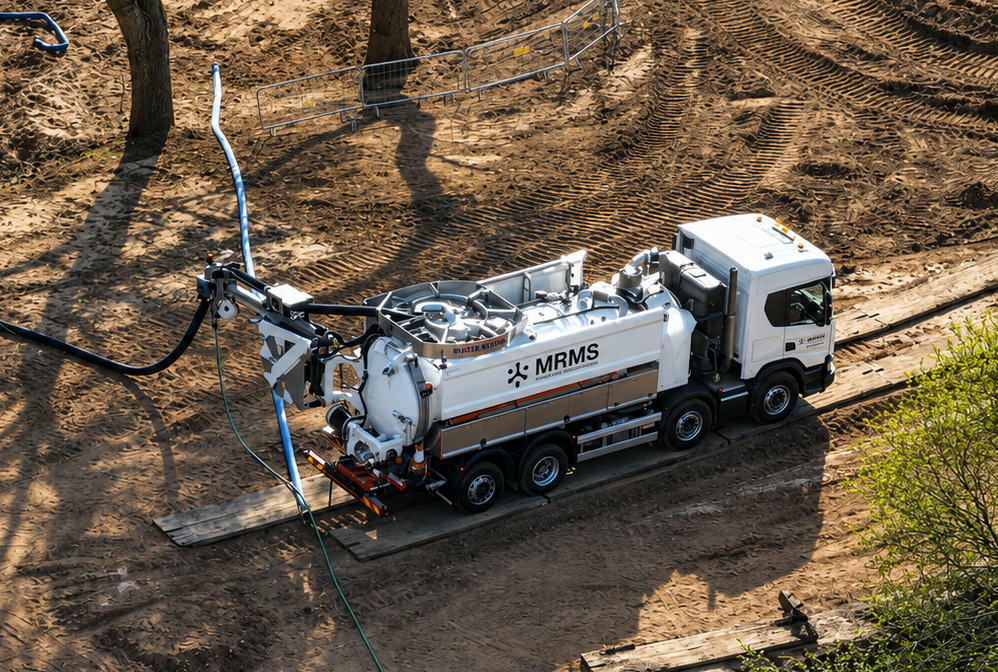

Material stockpiled at End B and loaded into 20-tonne haulage lorries for disposal.
Key Challenges & Highlights
Difficult Access

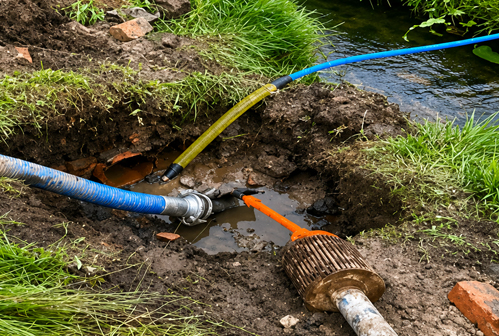

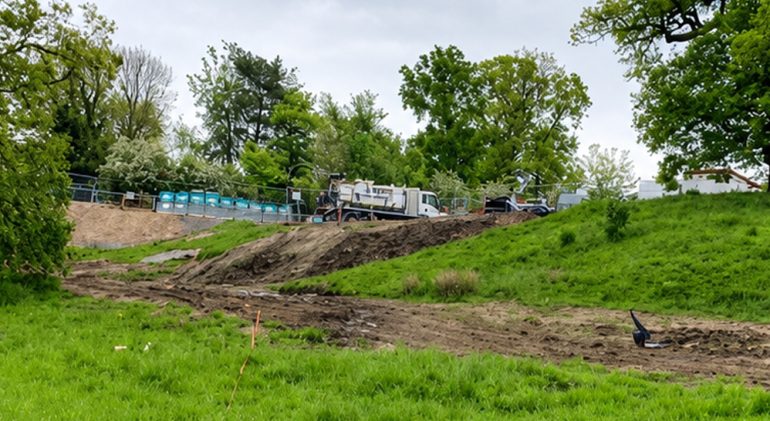

Inlet side became a sand pit from the canal breach. Outlet accessed via active plant track across wet farmland, requiring full portable setup.
Live Site Co-ordination
Works ran in tandem with ongoing major earthmoving operations, requiring continuous programme co-ordination to keep both scopes on track.
Technical Complexity

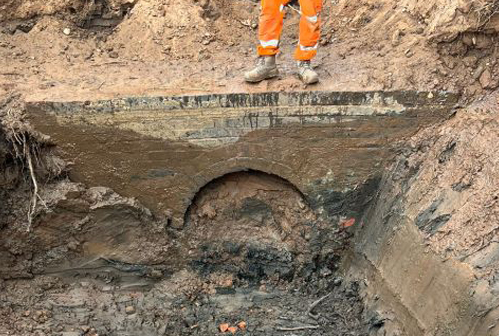

Culvert location and 100% silt blockage required multiple equipment configurations and expert planning to safely clean and survey.
Site photography
50m
Culvert
Cleaned
33m
Twin Pipes Cleaned
8 days
Programme
Delivered
<10%
Final Silt
Level
